Minnesota Department of Transportation

Stone Arch Bridge Preservation

Using Technology to Preserve History

LHB led the assessment and rehabilitation design of Bridge 27004, Minneapolis’ iconic Stone Arch Bridge, built in 1883. A 2017 week-long inspection using MnDOT’s Under Bridge Inspection Units informed LHB’s detailed Condition and Rehabilitation Assessment Report outlining defects, quantities, and projected costs. In 2019, LHB assembled multidisciplinary team—Collins, HNTB, WJE, SRF, and Braun Intertec—to navigate SHPO and MnDOT CRU reviews and develop preservation plans. The team created a photorealistic model of the bridge using drone data and documented conditions directly to the model. Rehabilitation included underwater grouting and repointing at granite pier bases, full repointing of limestone arches and spandrel walls, and selective stone re-facing. The project showcased engineering precision, historic sensitivity, and collaboration to preserve a nationally significant structure.

Project Type Historic Bridge Preservation
Location Minneapolis, MN
Completion Date July 2025
Size 2100-feet-long
Features & Highlights ACEC MN Grand Conceptor Award
ACEC MN Grand Award
ACEC MN QBS Award
190604_LeftRight1
Image Courtesy of Collins Engineers

Minneapolis Icon

Spanning the powerful currents of the Mississippi River, the Stone Arch Bridge has been a proud Minneapolis icon since 1883. Constructed from more than 100,000 tons of regional granite and limestone, the bridge was marred with deteriorating stones and mismatched repairs. Two simultaneously designed plansets allowed flexibility of scope and helped construction commence on time.

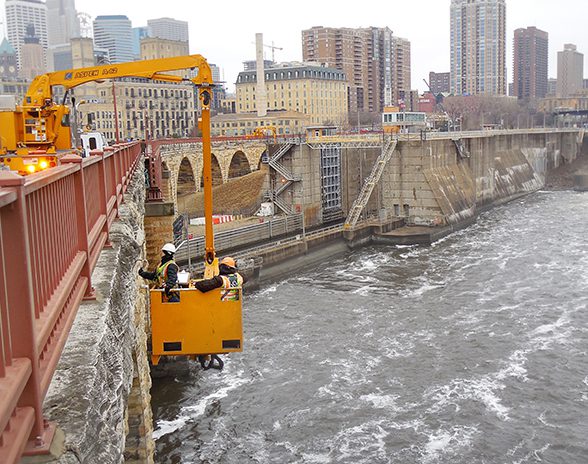

190604_LeftRight2

In-Depth Inspection

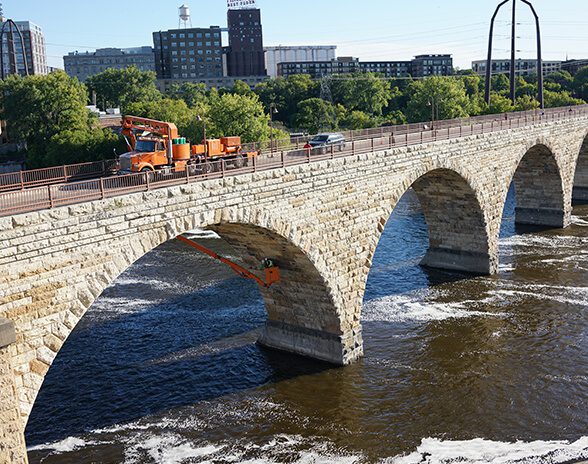

In 2017, Phase I began with LHB’s one week inspection using three snooper rigs and teams while keeping the bridge open. Findings showed the need for a more detailed inspection and preservation design, prompting MnDOT to seek funding and issue a Phase II RFP in 2019. Based on the 2017 results, LHB assembled a specialized team of subconsultants.

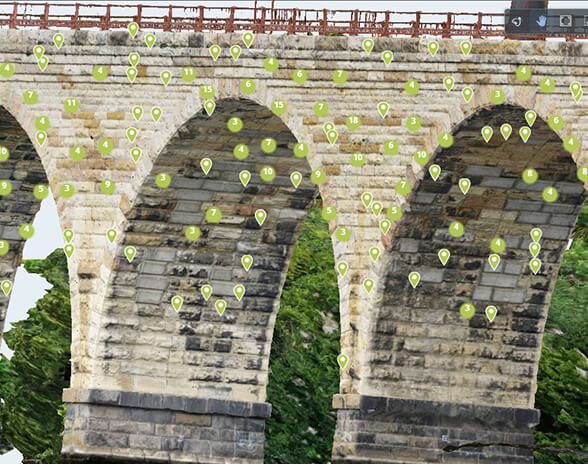

190604_LeftRight3
Image Courtesy of Collins Engineers

Digital Twin Model

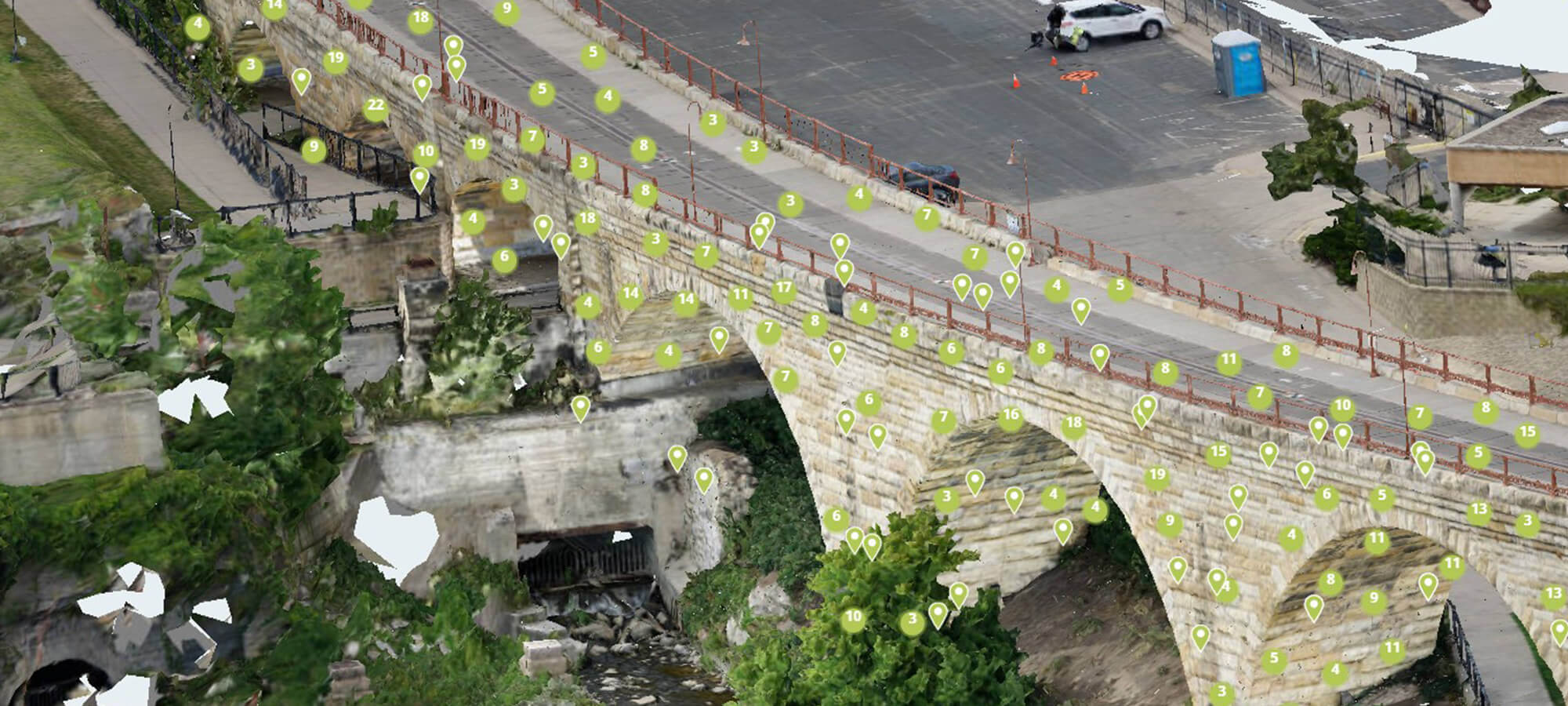

Drone operators and hands-on inspectors documented the bridge’s 19,000 limestone blocks and 4,000 granite stones. Using iPads with cellular connections they logged real-time defect notes on a cloud-based GIS “digital twin” model to help engineers define the project scope, resolve conflicts remotely, analyze metadata for defects, guide repairs, and provide MnDOT with a future maintenance tool.
